UAA Various Projects (2002- Present Day)

(projects are also listed under associated categories)




uaa MatSu Campus Bookstore Renovation 2015

In 2015, UAA publically bid the renovation of the UAA Matsu Campus Bookstore. As the successful bidder, Lake View General Contracting was tasked with the renovation of the bookstore including some minor demolition to accommodate the renovations. There was removal of the existing sales counter, racks, carpet, ceiling tiles and bookcases to accommodate new materials and casework.

  • Initial Construction Cost: $149,000
  • Final Construction Cost:  $172,630
  • NTP Date for Pre-Construction Services: 04/17/2015
  • Start of Construction: 05/18/2015
  • Substantial Completion Date: 07/20/2015
  • Final Completion Date: 09/20/2015
  • Project Manager:  Wes Warner
  • Project Superintendent: Dakota Wainwright
  • Primary Subcontractors: Alaska Abatement, Alaska Glass & Door, All Alaska Acoustics, Chinook, Encore, Precision, Rainbow Builders, Viking Drywall
  • Owner’s Information: UAA Project Manager, Howard Morse
  • Architect/Engineer:  McCool Carlson Green
  • Length of Business Relationship with Owner:  Since 2002
  • Cost Control Methods during Construction: Open Book Estimate


uaa KPC Art Ward Studio 2015

UAA publicly bid this project in February 2015. As the successful bidder, Lake View General Contracting began the renovation of 3,800 sf into an Art Studio located at Kenai Peninsula College in the Ward Building.  Construction began May 11, 2015 with Substantial Completion in September 2015.

  • Initial Construction Cost: $508,000
  • Final Construction Cost: $524,762
  • NTP Date for Pre-Construction Services: February 9, 2015
  • Start of Construction: May 11, 2015
  • Substantial Completion Date: September 15, 2015
  • Final Completion Date: November 18, 2015
  • Project Manager: Wes Warner
  • Project Superintendent: Jacob Braham
  • Primary Subcontractors: Absolute Services, Alaska Concrete Sawing, Carmody Masonry, Chinook Fire Protection, Kachemak Electric Co., Pioneer Door, RBI Specialty Services, LLC, Redoubt Industries, Specialty Excavating, Viking Drywall.
  • Owner’s Information: UAA Project Manager, Summer Sauve, 907.786.4900, smsauve@uaa.alaska.edu.
  • Architect/Engineer: McCool Carlson Green, 907.563.8474
  • Length of Business Relationship with Owner: 2002
  • Cost Control Methods during Construction: Open Book Estimate

UAA College Preparatory and Development Studies

UAA publicly bid this project in May 2015. As the successful bidder, Lake View General Contracting started this interior demolition and new construction located on the UAA Anchorage Campus in the Professional Studies Building.  Construction began May 20, 2015 with completion in August 2015. The project was completed on schedule with $68,367.00 in additional work.  The Substantial Completion Date was not impacted with the Certificate of Occupancy provided to UAA on August 19, 2015.



  • Initial Construction Cost: $353,400
  • Final Construction Cost: $421,767
  • NTP Date for Pre-Construction Services:
  • Start of Construction: May 20, 2015
  • Substantial Completion Date: August 19, 2015
  • Final Completion Date: August 19, 2015
  • Project Manager: Wes Warner
  • Project Superintendent: Jessie Hall
  • Primary Subcontractors: Alaska Glazing, All Alaska Acoustics Ceilings, Center Lines, Chinook, Haakenson Electric, Mechanical Specialists, Pac West, Rainbow Builders, Inc.
  • Owner’s Information: UAA Project Manager, Patricia Baum, 907.786.4918, pbgarcia@uaa.alaska.edu.
  • Architect/Engineer: ECI/HYER Architecture & Interiors, 907.561.5543
  • Length of Business Relationship with Owner: 2012
  • Cost Control Methods during Construction: Open Book Estimate

UAA Beatrice McDonald Hall Renewal

May 2013, Lake View General Contracting was awarded the UAA Beatrice McDonald Hall Renewal project. The team had to overcome several early permitting obstacles, which ultimately put the anticipated project schedule back several months. Lake View General Contracting worked quickly to make up for lost time, completing the 25,000 square foot interior remodel before classes started in January. Within the time frame of the original project, Lake View General Contracting also completed a large change order, adding fresh landscaping to the surrounding ground and painting the exterior of the building. Between the Owner and the Architects, significant design changes were established throughout the project. Lake View General Contracting worked readily with both parties to address and overcome these alterations.

  • Initial Construction Cost: $7,352,000
  • Final Construction Cost: $9,549,437
  • NTP Date for Pre-Construction Services: May 30th 2013
  • Start of Construction:  May 30th, 2013
  • Substantial Completion Date: 11/18/2015
  • Final Completion Date: 11/25/2015
  • Project Manager:  Wes Warner
  • Project Superintendent: Jacob Braham
  • Primary Subcontractors:  AlasCo, AK Concrete &Sawing, AK Demolition, All AK Acoustics, BC X, Chinook, Circle Plumbing, Colton Sprinklers, Commercial Contractors Del Norte Surveying, Denny’s Construction, Encore Electric, EP Roofing, Glacier Sign/Lighting, GMG General, Hansen Painting, Hotmud, JD Interiors, JD Steel, Lawn Tech, Mckinley Fence, Northern Office Supply, Otis Elevator, Pac West, Pile Co, Prostripe, Rainbow Builders, Siegel, SBS, Statewide
  • Owner’s Information: UAA, Project Manager, Patricia Baum
  • Architect/Engineer: Architects of Alaska
  • Length of Business Relationship with Owner: Since 2002
  • Cost Control Methods during Construction: Open Book Estimate

UAA School of Engineering Renovation

Renovation of approximately 2,630 sf of classroom renovation which includes EE-Lab and Thermal Lab located in the UAA Science Building.   The work consisted of renovating two classrooms (rooms 229 and 230) into a combined engineering lab, renovating a lab, offices and storage into a larger thermal systems lab (Lab 111), renovation of existing labs with new labs including storage, equipment and infrastructure improvements and all associated work for a complete and usable facility.



  • Initial Construction Cost: $204,576
  • Final Construction Cost: $210,899
  • NTP Date for Pre-Construction Services: June 14th, 2012
  • Start of Construction: 06/20/2012
  • Substantial Completion Date: 08/10/2012
  • Final Completion Date: 08/13/2012
  • Project Manager:  Ray Kizer
  • Project Superintendent: Wes Warner
  • Primary Subcontractors: Alaska Glass & Door, Center Lines, Chinook, Mega Watt, Mechanical Specialists, Rainbow Builders
  • Owner’s Information: UAA, Project Manager John Harrison
  • Architect/Engineer: Livingston Sloan Inc.
  • Length of Business Relationship with Owner:  Since 2002
  • Cost Control Methods during Construction: Open Book Estimate

uaa allied health services

In 2011 Lake View General Contracting publically bid the Renovation of approximately 4,825 square feet of classroom, which included x-ray and exam rooms constructed of hard walls and dirt wall systems.  This project also included a separation panel wall allowing the owner to break the room into two separate classrooms.  Between the Owner and the Architects, significant design changes were established throughout the project. Lake View General Contracting worked readily with both parties to address and overcome these alterations.

  • Initial Construction Cost: $597,600
  • Final Construction Cost: $617, 253.78
  • NTP Date for Pre-Construction Services: 04/03/2012
  • Start of Construction: 05/14/2012
  • Substantial Completion Date: 8/21/2012
  • Final Completion Date: 10/22/2012
  • Project Manager:  Wes Warner
  • Project Superintendent: Jacob Braham
  • Primary Subcontractors: Alaska Glass and Door, Centerlines, Chinook Fire Protection, Door Systems of Alaska, EP Roofing, Far North Surveying, Kuchar Construction, Mega Watt Electric, Miles Plumbing and Heating, Northern Services, Precision Woodworking, Rainbow Builders Inc.
  • Owner’s Information: UAA, Project Manager Patricia Baum
  • Architect/Engineer: Kumin Associates, Inc.
  • Length of Business Relationship with Owner:  Since 2004
  • Cost Control Methods during Construction: Open Book Estimate

UAA PWSCC Valdez Student Housing, Valdez, 2010

UAA publicly bid this project in March 2010.  The buildings were found to have asbestos containing materials so the owner has since revised Lake View’s contract to remove and replace the entire building interior finishes.

Total work included: hazardous material abatement, selective demolition and interior remodel of existing exterior walls, architectural finishes, kitchen and bath cabinetry, doors and frames, door hardware, plumbing fixtures, electrical lighting, party wall partition upgrades, general mechanical/electrical renovations, reconstruct civil parking areas, sidewalks and entry landings/steps. Refer to the Contract Documents for a more complete description of the Work.

  • Initial Construction Cost: $315,000
  • Final Construction Cost: $4,451,214
  • NTP Date for Pre-Construction Services: March 2010
  • Start of Construction: May 2010
  • Substantial Completion Date: September 2010
  • Final Completion Date: September 2010
  • Project Manager:  Ray Kizer
  • Project Superintendent: Wesley Warner
  • Primary Subcontractors: AlasCo General, Alaska Abatement, Alaska Glass and Door, EE Roofing, Mega Watt Electric, Precision Woodworking, Rainbow Builders, Simplex Grinnell, Tilmo Painting, Viking Drywall
  • Owner’s Information: UAA Project Manager, Howard Morse
  • Architect/Engineer: McCool Carlson Green Architecture
  • Length of Business Relationship with Owner:  Since 2002


UAA PWSCC Valdez Student Housing Concrete, 2010

While working on the student housing, Lake View replacement of approximately 1530 SF of existing 4” side walk to match existing.

  • Initial Construction Cost: $42,400
  • Final Construction Cost: $42,400

UAA BEtti Cuddy ATrium Lighting Track 2009

In 2009 Lake View General Contracting did a small contract for UAA. We provided the labor, materials and equipment necessary existing necessary to replace existing transformer located over the Betti Cuddy Atrium Coffee Car with a transformer capable of supporting the existing track and existing 4 fixtures.



  • Initial Construction Cost: $1,221,723
  • Final Construction Cost: $1,306,642
  • Start of Construction: 04/16/2009
  • Final Completion Date: 05/20/2009
  • Owner’s Information: UAA, Project Manager Kristin Reynolds

UAA Lucy Cuddy Hall Renovation 2008

Renovation of approximately 5,000 square feet of the main entry, which included a new coffee bar, stained concrete floors and glass wall. This project started May 5, 2008 and was substantially completed by August 15th 2008.

  • Initial Construction Cost: $1,221,723
  • Final Construction Cost: $1,306,642
  • NTP Date for Pre-Construction Services: February 28, 2008
  • Start of Construction: May 2008
  • Substantial Completion Date: September 2008
  • Final Completion Date: October 2008
  • Project Manager:  Ray Kizer
  • Project Superintendent: Wes Warner
  • Primary Subcontractors: AlasCo General, Alaska Concrete & Sawing, Alaska Foundation, Alaska Glass and Door, Andy Milner, Chinook Fire Protection, EP Roofing, Glacier Sign and Lighting, Ground Effects, Mechanical Specialists, Northland Tile, Precision Woodworking,
  •  Rainbow Builders, Sampson Steel, Samson Electric, Siegel Construction, Viking Drywall.
  • Owner’s Information: UAA, Project Manager Kristin Reynolds
  • Architect/Engineer: USKH, Inc.
  • Length of Business Relationship with Owner:  Since 2002
  • Cost Control Methods during Construction: Open Book Estimate

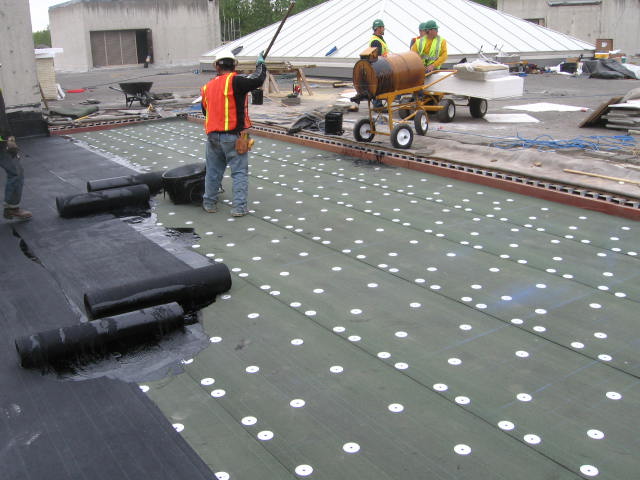

UAA CONSORTIUM Library RE-ROOF 2007

UAA had a competitive bid that consisted of removing the existing roof and replacing with a new EPDM roofing system over the Consortium Library. During this project we encountered changes in condition but we were still able to complete on time and within budget.



  • Initial Construction Cost: $1,776,996
  • Final Construction Cost:  $1,741, 872
  • NTP Date for Pre-Construction Services: 10/10/2002
  • Start of Construction: January 2008
  • Substantial Completion Date: May 2008
  • Final Completion Date: August 2008
  • Project Manager:  Wes Warner
  • Project Superintendent: Jacob Braham
  • Primary Subcontractors: Alaska Abatement, EP Roofing, JT Allison, Mechanical Specialists, Mega Watt Electric
  • Owner: UAA, Howard Morse Project Manager
  • Architect/Engineer: USKH, Inc.
  • Length of Business Relationship with Owner:  Since 2002
  • Cost Control Methods during Construction: Open Book Estimate

UAA MatSu College Classroom REnovation 2003

The project consisted of approximately 3100 .f. of renovated existing spaces, including the metal shop and wood shop. A 1150 S.F. existing canopy was enclosed in the new construction. The remodeled areas consisted of three classrooms, two of which were divided by an operable wall.  Demolition of the existing slab/floor and most existing interior walls/ceilings. New exterior walls were construction as well as a new roof. Additional cabinets were later decided to be added per the owner’s request. Electrical and Mechanical installed per contract as well.

  • Initial Construction Cost: 578, 013
  • Final Construction Cost: 678,698
  • NTP Date for Pre-Construction Services: 09/09/2003
  • Start of Construction: September 2003
  • Substantial Completion Date: 10/31/2003
  • Final Completion Date: 11/03/2003
  • Project Manager:  Ray Kizer
  • Project Superintendent: Wesley Warner
  • Primary Subcontractors: A-Z, AlasCo, Alaska Glass and Door, Architectural Hardware, Argus Fire, Arctic Sun, Best Masonry, Door Specialties, Gold Dust Acoustics, Janes Brothers, M&M, Mechanical Specialists, Pac West, Ptarmigan Steel, Rainproof Roofing, Simplex Grinnell, Weldin Electrical.
  • Owner’s Information: UAA Project Manager, George Stevens
  • Length of Business Relationship with Owner:  Since 2002

UAA Ortner House 2002

UAA publicly bid this project in May 2002. Lake View General Contracting constructed and entire new build for the MSC Ortner Warehouse Replacement /Maintenance Facility.

  • Initial Construction Cost: 535,500
  • Final Construction Cost:  584,985
  • NTP Date for Pre-Construction Services: 05/10/2002
  • Start of Construction: May 2002
  • Substantial Completion Date: 09/19/2002
  • Final Completion Date: 09/24/2002
  • Project Manager:  Ray Kizer
  • Project Superintendent: Wesley Warner
  • Primary Subcontractors: AlasCo General, Alaska Glass and Door, Andy Milner, AS&G, Denny’s Construction, Fasteners and Fire, GMG General, General Mechanical, Simplex Grinnell, Rainbow Builders, Summit
  • Owner’s Information: UAA Project Manager, George Stevens
  • Length of Business Relationship with Owner:  Since 2002
